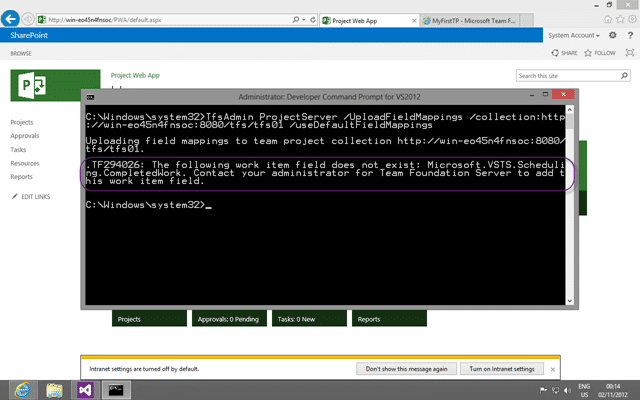

When you try to upload the default field mappings for Project Server 2013 integration with Team Foundation Server 2012 you can encounter a TF294026: The following work item field does not exist error.
Figure: TF294026: The following work item field does not exist
With the message:
TF294026: The following work item field does not exist: Microsoft.VSTS.Scheduling.CompletedWork. Contact your administrator for Team Foundation Server to add this work item field.
You are unable to continue without fixing…
Applies to
- Project Server 2013
- Team Foundation Server 2012
- Project Server Extensions for Team Foundation Server
Findings
Project Server requires that you have data for Remaining Work, Completed Work and Original Estimate for it to function correctly.

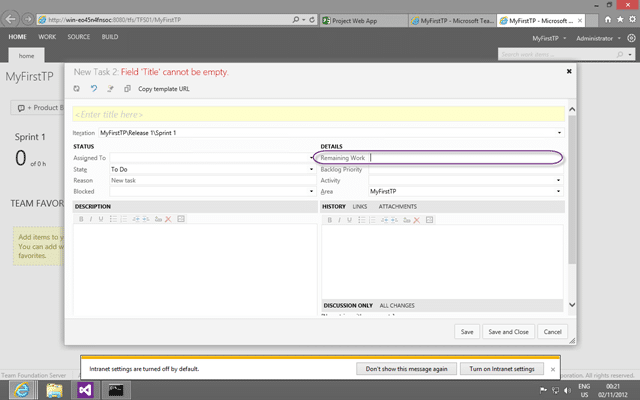

Figure: The Task Work Item Type only includes Remaining Work
The Visual Studio Scrum Process Template however does not include these as they are not required for Scrum.
Solution
Use the instructions on Required Changes to Make When Mapping to a Team Project That Was Created From the Scrum Process Template to update the Task Work Item Type for the Visual Studio Scrum 2.0 template to add both the Completed Work and Original Estimate fields.
Warning The documentation on MSDN is currently out of date and misses two fields that need to be added. Make sure that you also add the Start and End dates.
The number of units of work that have been spent on this task
Initial value for Remaining Work - set once, when work begins.
Figure: Add both Original Estimate and Completed Work
Although we are adding these fields to the Task type we are not necessarily adding them to the UI for users to fill out. We can leave them available for Project Server, while out Team Members of a Scrum Team would be blissfully ignorant of their existence.
Smart Classifications
Each classification [Concepts, Categories, & Tags] was assigned using AI-powered semantic analysis and scored across relevance, depth, and alignment. Final decisions? Still human. Always traceable. Hover to see how it applies.
What to read next
Issue [ TFS 2013 ] Value cannot be null. Parameter name: key
Explains how a missing required Team Field in customised TFS 2013 work item templates causes "Value cannot be null" errors, and how to …
Detecting agile theatre with real delivery signals
Why Most Companies Operating Models Fail in Dynamic Markets
A concise comparison of Predictive and Adaptive Operating Models, explaining why traditional structures fail in dynamic markets and how …
Don’t Manage Dependencies, Remove Them
Explains why dependencies are a sign of poor system design and outlines steps to eliminate them by aligning teams, clarifying ownership, and …
The Estimation Trap: How Tracking Accuracy Undermines Trust, Flow, and Value in Software Delivery
Tracking estimation accuracy in software delivery leads to mistrust, fear, and distorted behaviours. Focus on customer value, flow, and …
Flow of Value vs Flow of Work – Misnomer or Useful Shorthand?
Compares “flow of value” and “flow of work” in Kanban, explaining why only validated outcomes count as value and stressing the need for …
Why Outsourcing DevOps Fails, and How Real Engineering Excellence Starts With Your Team
Avoid DevOps vendor lock-in, discover how true engineering excellence starts with partnership, not outsourcing. Ready to transform your …
The Definition of Done is a Commitment to Quality
Defines the Definition of Done in Scrum as a clear, shared standard for quality, ensuring increments are releasable, transparent, and …
Why Your Definition of “Done” Is Holding Back Quality, Agility, and Trust, And How to Raise the Bar
Is your team’s “done” really done? Discover how a clear, objective definition of done boosts quality, agility, and trust in product …
Acceptance Criteria vs Definition of Done: Why Getting This Right Builds Trust and Delivers Quality Faster
Stop confusing acceptance criteria with definition of done, learn the crucial difference to boost quality, speed, and trust in your agile …
How to Evolve Your Definition of Done: Start Small, Grow Smarter, and Build Lasting Momentum
Unlock a smarter Definition of Done, start small, evolve standards, and build team momentum without overwhelm. Discover how progress drives …
Why Most Transformations Fail Without Honest Conversations
Most transformations fail without open, honest conversations that address real issues, making transparency and tough dialogue essential for …
Why Your Definition of Done Is the Secret Weapon for Real Business Impact and Agile Growth
Transform your definition of done into a strategic advantage, deliver real value, reduce risk, and drive business impact with every sprint.
